The useful price question is not “What does a crumb rubber machine cost?” It is “What will it cost to produce the specified crumb, at the accepted finished rate, with the plant actually installed and ready to run?”
YUXI crumb rubber plant showing tire shredder rasper granulator and grading screen
A crumb rubber project is a connected production system. The budget changes with the starting material, finished grade and equipment boundary.
This guide treats crumb rubber plant cost as a project-budget problem rather than a public price-list problem. YUXI’s Tire Rubber Crumb Plant provides the technical boundary for that discussion: the project can begin with whole tires or with prepared wire-free chips, while the final equipment scope depends on the required crumb grade and accepted finished capacity.
One supplier may start at whole tires. Another may assume that 10–20 mm wire-free chips are already arriving at the granulator. One price may include conveyors, grading, fiber removal and a dust system; another may stop at the core machines. Freight, foundations, local electrical work and commissioning may be missing from both. The lower number is not automatically the lower project cost.

What a Crumb Rubber Plant Budget Must Include

Start with five definitions: feed boundary, finished product, accepted capacity, supply boundary and site boundary. Only then should a price be compared.
For budgeting, separate the supplier’s process-equipment price from conveying and storage, controls and electrical distribution, dust collection, freight and import costs, civil works, mechanical and electrical installation, commissioning, initial wear parts and contingency. Keep working capital—tire inventory, packaging inventory, receivables and finished-goods stock—outside the installed-plant figure so the investment model stays readable.

Define the Cost Boundary Before Asking for a Number

The phrase plant cost is dangerously elastic. It can mean the factory price of one granulator, an FOB line package, a landed equipment cost, or a commissioned facility with local utilities and foundations.

Feed boundary

Whole passenger and truck tires? Pre-cut sections? 50 mm chips? Or 10–20 mm wire-free rubber? Moving the feed boundary upstream adds machines, drives, conveyors and wear parts.

Product boundary

“Crumb rubber” is not enough. Define the saleable size range, oversize and fines rules, steel and fiber limits, moisture expectations and packaging point.

Project boundary

State whether the quote stops at factory supply, arrives at the port or site, or includes installation, commissioning, training and performance testing.
This is also the cleanest way to avoid confusing crumb rubber with coarser mulch or with fine powder. If that product boundary is still open, the comparison of rubber mulch vs crumb rubber helps decide whether the project should stop at a coarse, wire-free product or continue into granulation and tighter classification.

Three Project Scopes Can Sit Behind the Same “Crumb Rubber Plant” Search

For a real RFQ, separate the scope first.
Budget scopeStarting materialMain equipment depthWhat changes the budget most
Downstream crumb modulePrepared 10–20 mm wire-free chipsGranulation, secondary magnetic recovery, grading, oversize return, fiber separation, connecting conveyors and controlsTarget crumb grade, accepted t/h, number of saleable fractions, fiber limit, dust collection and storage/packing interface
Complete whole-tire-to-crumb lineWhole tires or mixed approved tire feedAdds tire preparation where required, primary shredding, rasper processing, first magnetic recovery and upstream handling before the crumb moduleTire mix and maximum size, preprocessing, primary chip control, steel liberation, extra conveyors, installed power and workshop footprint
Crumb plus fine-powder expansionClean crumb rubberAdds another grinding and fine-classification stage beyond the crumb routeMesh target, heat and dust management, energy, fine separation and lower practical throughput at finer grades
YUXI crumb rubber plant equipment stages from debeading and shredding to granulation screening and fiber separation
Whole-tire projects carry the upstream machines and handling cost that a prepared-chip granulation module does not.

Which Equipment Actually Creates the Crumb Rubber Plant Cost?

A useful cost breakdown follows the material rather than the supplier’s quotation headings. That makes missing stages easier to spot.

1. Feed preparation and primary reduction

If the line begins with whole tires, the budget may include tire handling, bead or sidewall preparation for particular tire categories, primary shredding, screening or return routing, and the conveyors between those machines. Large or heavily reinforced tires can change the upstream scope substantially. A standalone shredder price is therefore not a proxy for a crumb plant; our guide to tire shredder machine price explains why machine-only and system quotations need separate boundaries.

2. Steel liberation and magnetic recovery

The rasper is doing more than making smaller pieces. It has to expose steel so the magnet can actually recover it. A whole-tire line therefore carries both the cutting duty and the steel-recovery duty. If the project buys clean 10–20 mm chips, much of this cost has already been transferred to the upstream supplier.

3. Granulation

The granulator takes the clean, coarser rubber toward the saleable crumb range. Its size, motor and knife duty must be matched to accepted output—not just to the easiest material shown in a short test. Finer targets usually increase specific cutting work and recirculation.

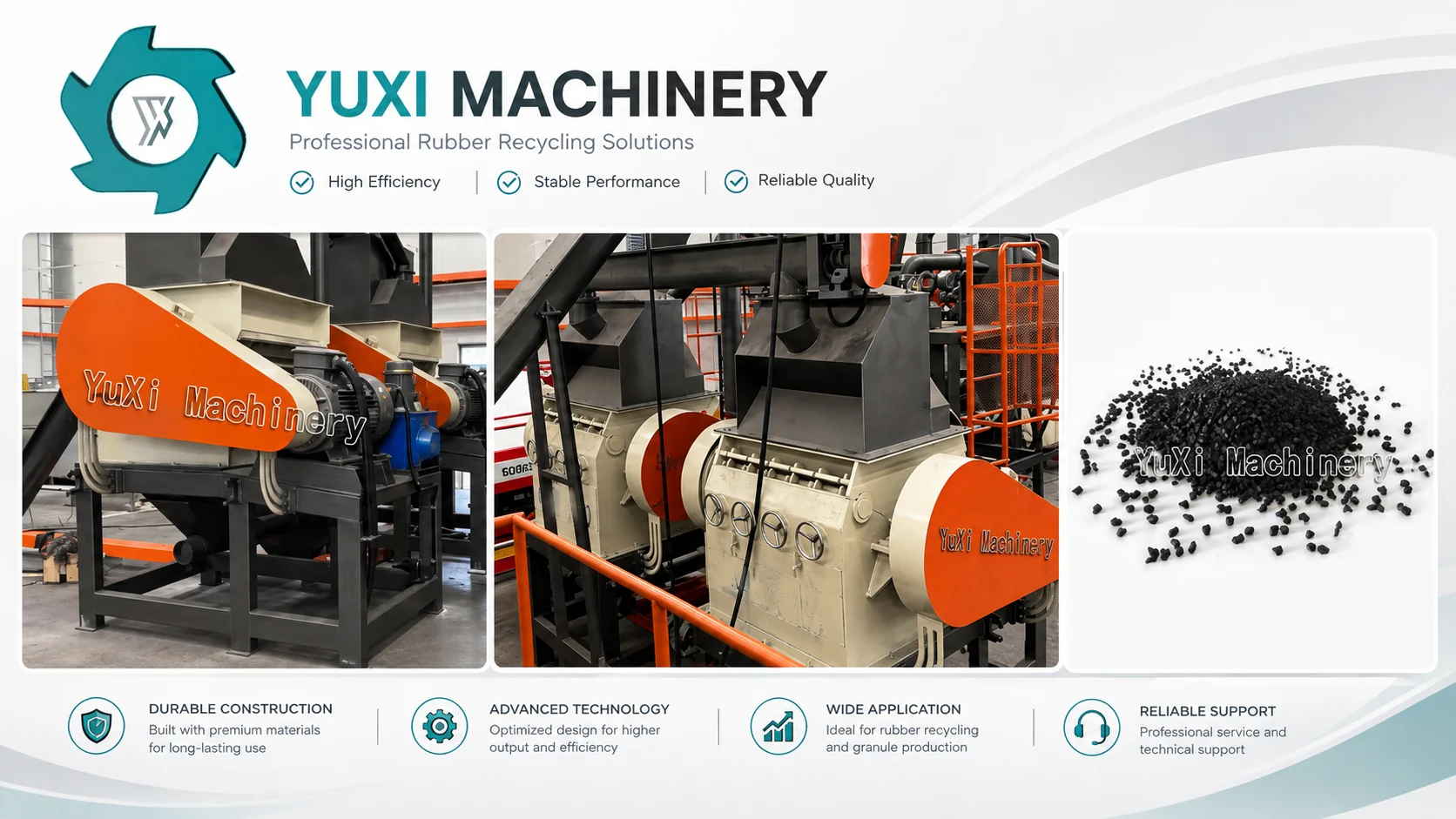

YUXI rubber granulator and crumb rubber output for tire recycling
The granulator is only one cost center. Finished product still depends on magnetic cleanup, grading, return material and fiber control.

4. Grading screen and oversize return

Screens do not simply “check” the product. They define which material becomes saleable and which material goes back for more work. A return conveyor, transfer points and controls are part of the production loop, not optional decoration. When a buyer asks for a narrow fraction, return load can become one of the hidden limits on accepted t/h.

5. Secondary magnet and fiber separation

EPA describes tire crumb production as staged size reduction with sifting screens that return oversize, magnets that remove wire and air separators that remove fabric.1 That is why a low-cost line that deletes or undersizes separation stages may create a higher rejection cost later. If your market needs a written cleanliness target, use the tire rubber granule plant purity guide to define how steel, fiber, screening and sampling will be checked instead of relying on a single percentage in a brochure.

How 0.5–10 t/h Capacity Changes the Budget

The YUXI pillar publishes a configurable 0.5–10 t/h reference feed range. That is a useful project envelope, but it is not a promise that every 10 t/h feed condition will make 10 t/h of accepted 0–5 mm crumb. Tire construction, screen cut, return load and separation duty all affect the finished rate.
This is where many cost comparisons break. A supplier can size a shredder for a high feed rate while a downstream granulator, screen or fiber separator sets the saleable output. The plant is only as productive as its slowest stage after the system reaches steady state.
Capacity decisionWhat tends to change physicallyBudget implication
Higher accepted t/hLarger or additional process duty, wider conveyors, stronger drives, more separation and handling capacityCore machinery rises, but not in a perfectly linear ratio
More operating hoursWear-part consumption, maintenance windows, spare strategy and storage turnover become more importantInitial spares and service planning deserve more budget even if nameplate capacity is unchanged
Tighter product fractionMore screening selectivity and oversize returnInstalled equipment may look similar while accepted output falls; cost per saleable ton can rise
Mixed truck/passenger feedVariable steel, rubber mass, stiffness and chip behaviorNeeds representative testing and capacity margin rather than a single ideal-feed figure
Future expansionReserved floor space, electrical capacity, conveyor interfaces and bin locationsSmall design cost now can avoid expensive layout changes later
Required accepted crumb t/h ≠ nominal upstream feed t/h

The Finished Crumb Specification Can Change Cost More Than Buyers Expect

YUXI’s crumb line is positioned around a primary 0–5 mm product direction, with exact distributions set by the screen and grading arrangement. Buyers may instead need 1–3 mm, 3–5 mm, a broader 1–8 mm fraction or a market-specific sieve curve. Those are different production contracts.
The deeper lesson is that size and cleanliness belong in the budget together. A road-material buyer, a molded-rubber producer and a sports-surface buyer may all purchase “crumb rubber” while applying different gradation, wire and fiber limits. FHWA’s asphalt-rubber guidance, for example, reproduces state specifications with defined sieve curves and very low wire and fabric limits for certain crumb-rubber modifier applications.2 A plant should not be priced for “0–5 mm” and then discover that the actual buyer needs a narrower, cleaner grade.

Coarser or broader grade

Usually allows a larger share of material to leave the line after fewer reduction passes. That can reduce return duty, but only if the buyer accepts the distribution and cleanliness.

Finer or narrower grade

Usually increases cutting, classification and recirculation duty. More transfer points and finer material also make dust control and housekeeping more important.

Lower residual steel

May require stronger staged liberation, multiple magnetic recovery points and better burden control rather than one oversized magnet at the end.

Lower visible fiber

Requires airflow control, stable feed presentation and collection equipment. Excess airflow can remove useful rubber with the textile stream, so capacity and yield need testing together.

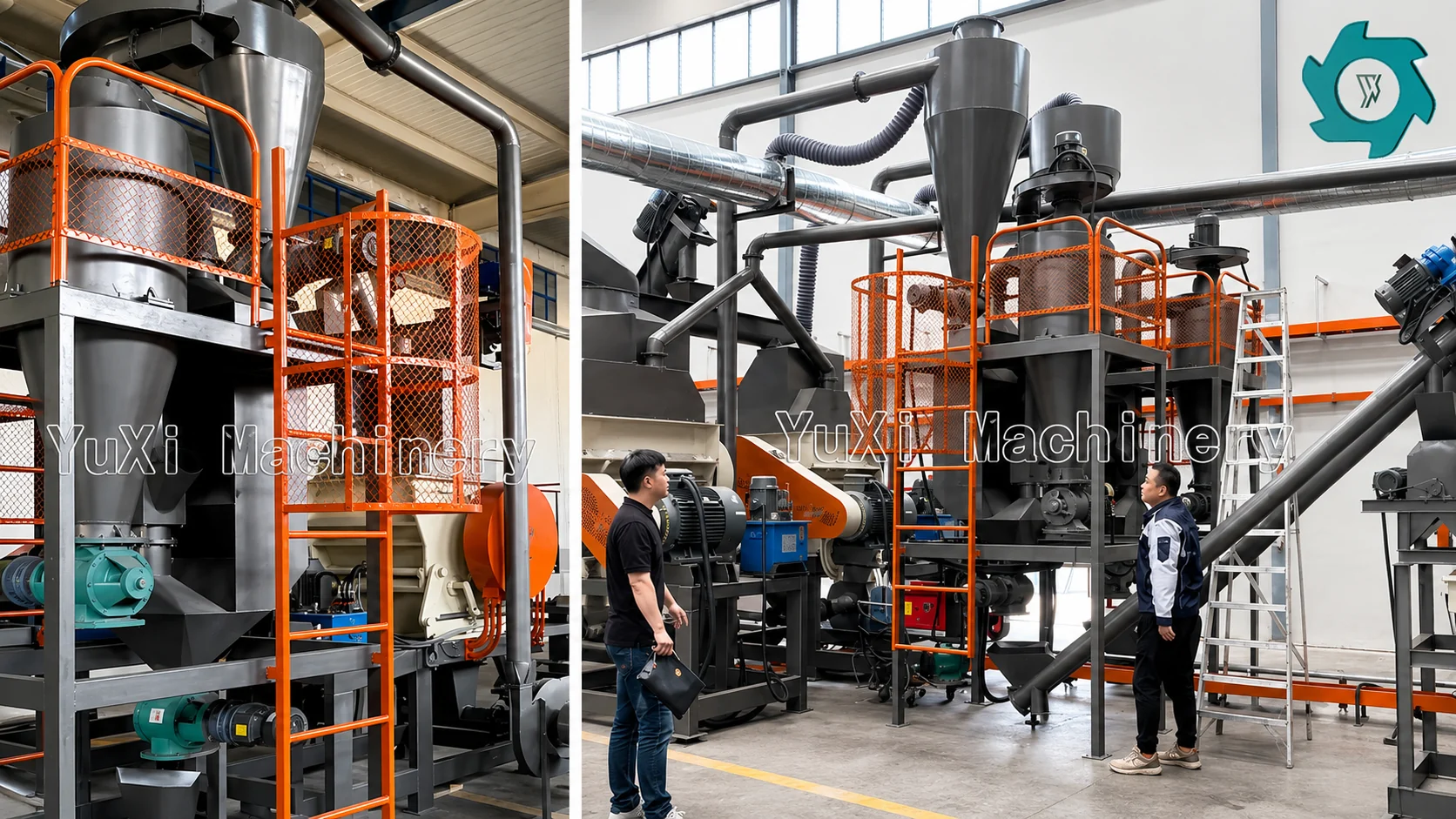

YUXI fiber separation and dust handling equipment in a crumb rubber plant
Separation and dust handling are part of product quality and plant integration, so they belong in the budget from the start.

Equipment Price Is Not the Total Installed Budget

For early feasibility work, we use a simple equation. It does not create a fake universal multiplier; it forces every cost category to appear somewhere.
Total Installed Budget = Process Equipment + Plant Interfaces + Landed Logistics + Site Works + Installation + Startup + Initial Spares + Contingency
Budget lineWhat belongs hereWhat to ask for
Process equipmentShredder/rasper where needed, granulator, magnets, screen, return system, fiber separator, local machine controlsDetailed equipment list, motors, major wear parts, battery limits
Plant interfacesConnecting conveyors, feed hoppers, bins, discharge interfaces, packing points, central controls and guardingLayout, elevations, conveyor list, included steelwork and access platforms
Dust and housekeeping systemsExtraction points, ducting, collectors and project-specific protection measuresDust-generation assumptions, collection scope, local code responsibility
Landed logisticsExport packing, inland transport, ocean/land freight, insurance, port handling, customs and duties where applicableIncoterm, container plan, dimensions/weights, destination assumptions
Site worksBuilding modifications, foundations, pits, floor loading, drainage, compressed air, lighting and utilitiesFoundation loads, anchor plans, utility list and site exclusions
ElectricalTransformer where required, MCCs, cables, trays, local panels, field wiring and power-quality workTotal connected load, voltage/frequency, starting method, cable boundary
InstallationMechanical erection, electrical termination, lifting equipment, alignment and site supervisionWho supplies labor, cranes, tools, accommodation, permits and consumables
Startup and acceptanceCommissioning, training, test material, sampling, performance test and punch-list closureTest duration, feed lot, product acceptance rule and responsible parties
Initial sparesKnives, screens, belts, bearings, filters and other recommended startup inventoryOne-year or agreed operating-hours spare recommendation with unit quantities
ContingencyUnresolved site interfaces and design maturity—not a substitute for missing scopeList known unknowns; reduce contingency as engineering is completed
Keep land, permits, tax and working capital visible but separate. They may be material to the business case, yet they are highly location-specific. Combining them into a generic “machine price” makes both supplier comparison and financial modeling worse.

Site Costs Are Where a Cheap Machine Quote Often Stops Being Cheap

A crumb line has more interfaces than a single shredder. Every transfer point needs physical support, access, guarding, electrical connections and a housekeeping plan. The finer the product becomes, the less acceptable it is to treat dust management as an afterthought.

Electrical supply and transformer capacity

Confirm voltage, frequency, available transformer capacity, starting current strategy and the distance from the power room to the machines. A factory quotation may show installed motor power without including the transformer’s cost, local cabling, cable trays or electrical inspection.

Foundations, floor loading and maintenance space

The lowest-footprint layout is not always the lowest installed cost. If a granulator cannot be opened without dismantling a conveyor, or a screen has no space for mesh replacement, maintenance will consume the savings later. Ask for service envelopes, lifting points and foundation loads before the building is finalized.

Dust collection and fire-risk engineering

Rubber size reduction can create fines, and OSHA identifies tire and rubber manufacturing among industries where combustible-dust hazards can occur.3 The correct protection concept depends on the actual dust characteristics, equipment, ducting and local rules, so a cost article should not prescribe one universal system. It should insist that collection, housekeeping, ignition control and local code responsibility are defined before the plant budget is frozen.

Freight, customs and unloading

Container count and oversize pieces matter. So do destination port, inland haulage, crane access and import duties.Ask the supplier to provide the packing list and loading plan as early as possible. Otherwise, logistics can remain a rough allowance until late in the project instead of becoming part of a realistic installed-cost estimate.

CAPEX Alone Does Not Tell You the Cost per Saleable Ton

A plant with a lower purchase price can be more expensive to own if it consumes more knives, loses rubber into the fiber stream, runs a large oversize loop or needs frequent manual cleaning. We therefore keep a small operating-cost model beside the capital budget during supplier comparison.
Operating-cost driverWhat to measureWhy it changes the decision
ElectricitykWh per accepted ton, not only total installed kWUtilization and recirculation change actual consumption
Knife and screen wearCost per operating hour or accepted ton under the real tire mixTruck-heavy or contaminated feed can change replacement frequency
LaborOperators per shift plus maintenance and material handlingAutomation may move labor rather than eliminate it
Rubber yieldAccepted crumb, steel, textile, fines and rejects by weightLosing saleable rubber to a side stream can erase a small CAPEX saving
Dust filters and housekeepingFilter consumption, cleaning time and waste handlingFine material creates a recurring service duty
DowntimeProductive hours versus scheduled hoursAnnual economics depend on availability, not brochure t/h
Ground rubber already serves established end markets such as rubber-modified asphalt, athletic surfaces, automotive parts and industrial materials. USTMA reported that ground-rubber markets consumed about 28% of U.S. end-of-life tires in 2023.4

How to Compare Three Crumb Rubber Plant Quotations Without Being Misled

Do not start with the total. Start with a compliance sheet. Put the same project basis at the top of all three columns and force every supplier to answer included, excluded or deviation.
Comparison fieldSupplier ASupplier BSupplier C
Approved tire mix and maximum sizeIncluded / deviationIncluded / deviationIncluded / deviation
Starting material conditionWhole tire / chip sizeWhole tire / chip sizeWhole tire / chip size
Accepted crumb gradeWritten sieve ruleWritten sieve ruleWritten sieve rule
Accepted finished t/hTest basisTest basisTest basis
Steel and fiber acceptanceMethod + limitMethod + limitMethod + limit
Screen-return loopIncluded?Included?Included?
Dust systemIncluded / battery limitIncluded / battery limitIncluded / battery limit
Conveyors, bins and platformsComplete listComplete listComplete list
Controls and electrical boundaryScopeScopeScope
Recommended initial sparesQuantity + priceQuantity + priceQuantity + price
Freight / IncotermBasisBasisBasis
Installation and commissioningScopeScopeScope
Performance testFeed, duration, samplingFeed, duration, samplingFeed, duration, sampling
Practical check: If one quotation is dramatically cheaper, first look for a moved boundary—not a miraculous machine. Common differences are prepared-chip feed instead of whole tires, no automatic oversize return, reduced fiber cleanup, fewer conveyors, no dust collection, a different capacity measurement point or installation excluded.

A Budget Worksheet That Can Survive the RFQ Stage

Before asking for a final quotation, put the project into one page. The exercise often exposes missing commercial decisions earlier than another round of supplier emails.
  • Feed: passenger/truck/other tire mix, maximum dimensions, contamination rule and whether beads or sidewalls are pretreated.
  • Starting boundary: whole tires, primary chips or purchased 10–20 mm wire-free material.
  • Product: required crumb fraction(s), sieve distribution, oversize/fines rule, residual steel, textile fiber, moisture and packaging.
  • Capacity: accepted finished t/h, annual saleable tons, shifts, scheduled hours and required availability.
  • Site: workshop plan, clear height, floor/foundation condition, ambient conditions and maintenance access.
  • Utilities: voltage, frequency, transformer capacity, compressed air if needed and available extraction/ventilation infrastructure.
  • Automation: manual loading points, central controls, interlocks, level sensing, return automation and packaging interface.
  • Destination: Incoterm, port/site, local duties and unloading restrictions.
  • Services: layout engineering, installation supervision, commissioning, training, acceptance test and documentation language.
  • Spares: agreed operating-hours or one-year package for knives, screens, belts, bearings and filters.
For whole-tire projects, it also helps to map the upstream material route before the RFQ. The guide on how waste tires are reduced into controlled wire-free rubber shows why the shredder, rasper and magnetic stages must deliver a stable feed before granulation cost and capacity can be judged properly.

Cost-Estimating Mistakes That Distort a Crumb Rubber Project

Comparing FOB machinery with an installed plant

These are different financial numbers. Rebuild every quote to the same boundary before comparing totals.

Using input tons instead of accepted crumb tons

A line can accept a high mass flow and still miss the finished-output target because of return load, separation limits or downtime. Put the accepted product at the measurement point.

Choosing capacity before validating the buyer’s product

A 0–5 mm request is still incomplete if the buyer actually pays for a narrow 1–3 mm grade with strict steel and fiber limits. Market specification comes before final machine sizing.

Leaving dust, electrical and civil scope to “later”

Those items are precisely where site geography creates the largest variation. Getting them into the first budget produces a less attractive number—but a more useful one.

Buying the lowest machine price without a wear and test basis

Knives, screens, belts and bearings are not small details in a size-reduction plant. Ask what feed was used for the performance claim, what wear state was present and which spare package supports the planned annual hours.

FAQ

How much does a crumb rubber plant cost?
There is no dependable universal number because the scope may start with whole tires or with prepared 10–20 mm wire-free chips, and quotations may include very different amounts of conveying, separation, dust collection, controls, freight, installation and commissioning. Compare the same feed boundary, finished product specification and installed scope before comparing price.
What is included in a complete crumb rubber plant budget?
A total installed budget can include core processing equipment, magnets and fiber separation, screens and return conveyors, material handling, controls and electrical distribution, dust collection, freight and import costs, foundations, mechanical and electrical installation, commissioning, initial wear parts and contingency. Local taxes and working capital should be shown separately.
Does a 10 t/h crumb rubber plant cost ten times as much as a 1 t/h plant?
Not necessarily. Capacity does not scale linearly with price. Larger projects need heavier machines, conveying, electrical distribution, dust handling, storage and service access, but many fixed engineering and control costs do not multiply directly with hourly capacity. Finished-size requirements and recirculation can also change the relationship.
Why does finer crumb rubber increase project cost?
Finer or tighter product grades usually require more size-reduction work, more screening and recirculation, tighter steel and fiber control, and more dust handling. The accepted finished throughput can therefore fall even when the upstream feed rate is unchanged.
What should I send a supplier for an accurate crumb rubber plant quote?
Send representative tire photos and size range, tire mix, starting material condition, target crumb grades and tolerances, accepted finished tons per hour, steel and fiber limits, operating hours, local voltage and frequency, workshop dimensions, destination, automation preference and the installation and commissioning scope you expect.
Is equipment price the same as total installed cost?
No. Equipment price may stop at an EXW or FOB machinery package. Total installed cost adds the project-specific items required to make that machinery operate at the site, such as freight, unloading, foundations, electrical work, dust systems, installation, commissioning, spares and local compliance work.

Build the Quote Around Accepted Crumb, Not a Machine List

Send YUXI your tire mix, starting material, target crumb fraction, accepted finished t/h, steel and fiber limits, operating hours, workshop plan, local power and destination. The proposal can then separate the process-equipment price from the items that belong in your total installed budget.
